Progress

CLAYTON J. LLOYD INTERNATIONAL AIRPORT
REDEVELOPMENT PROGRAM

Package 1 - Enabling Works - Complete:

​MARCH 2024 UPDATE

  • Temporary Car Park - Accommodates displaced parking in the location of the new terminal. The car park will be integrated into the landside expansion associated with the new ATB construction.

  • Apron Expansion - Provides a safe parking area, power in-out for E190 aircraft, and as the first phase towards expanding/infilling apron up to the new ATB.

  • Partial Parallel Taxiway - Enabling the relocation of Cargo building and future apron infill.

Package 2 - New Passenger Terminal and Cargo Building - Complete:

AUGUST 2024 UPDATE

  • Cargo Building Operating as a standalone facility

  • Cargo relocated from old facility to new facility storage bay

  • Signage Installation Complete

  • Furniture Installations Complete

  • Apron Commissioning In Progress


JULY 2024 UPDATE

  • Exterior/Interior Finishes Complete

  • HVAC, Plumbing & Electrical Complete

  • Landside Paving, and Security Gate Installation Complete

  • Signage Installation Ongoing

  • Furniture Assembled and Delivered to site


JUNE 2024 UPDATE

  • Majority of Exterior Finish installation Complete

  • Majority of Interior Finishes Complete (some minor touch-ups are required, one last coat of paint, floor polishing, and ceiling tiles once the electrical and HVAC is completed)

  • Majority of HVAC and Electrical Installations Complete

  • Exterior Doors, Windows and Shutters Installed

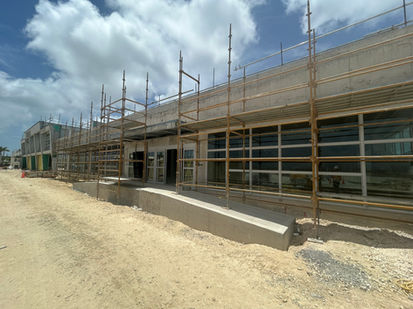

MAY 2024 UPDATE

  • Majority of Exterior Primer installation Complete

  • Interior Finishes ongoing – high bay ceiling has been painted, majority of tiles installed, washroom tiling/painting complete (just require fixtures and misc finishes), majority of drywalling complete

  • HVAC and Electrical installations ongoing

  • Landside kerb and sidewalks poured. Next will be ramps and steps

  • Site Services installations ongoing (no pictures here)

  • Enabling works on mahogany road complete (no pictures here unless you’d want them – most of the area is now backfilled)​

​

APRIL 2024 UPDATE

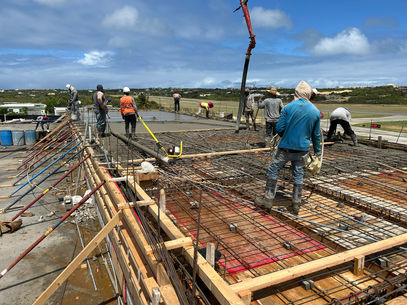

  • New Cargo Building - All Cargo building roof slabs formed, poured, and cured. Exterior Wall Render Completed

  • New Cargo Apron - Airside and Landside Excavation ongoing (in preparation for apron)

  • New Carpark - Airside and Landside Excavation ongoing (in preparation for new parking lot)

  • New Service Road

  • Utility Works for the Air Terminal Building - Electrical Rough-Ins Completed

​

MARCH 2024 UPDATE

  • New cargo Building

  • New cargo Apron

  • New carpark

  • New Service Road

  • Utility Works for the Air Terminal Building

Package 3A -  Terminal Building & Landside Facilities - Completed

DECEMBER 2025 UPDATE

  • Air Terminal Building Grand Opening Ceremony Held on December 12th.

  • Air Terminal, Apron and Landside fully commissioned and in Operation on December 15th.

  • Phase 1 of Package 3 Complete. Phase 2 to formally commence on January 5th with the demolition of the old terminal.


NOVEMBER 2025 UPDATE

  • Wall and Floor tiling completed.

  • Drywalling completed throughout building.

  • Roof system installation complete.

  • Mechanical infrastructure installations complete and commissioned.

  • Exterior stucco installation completed.

  • Washrooms finish installations complete.

  • Ceiling installations complete.

  • Electrical energizations completed..

  • Millwork installations complete (final alignments being completed)

  • Baggage Handling systems installations Completed.

  • Furniture installations ongoing.

  • Focus placed on cleaning and snag list/deficiency work.

  • Firs portion of apron opened for operations (otherwise all phase 1 apron work complete).

  • Operational date of new terminal scheduled for December 15.


OCTOBER 2025 UPDATE

  • Majority of architectural finishes complete throughout building – final railing, tile remediations, and final check-in hall coat of paint and touchups remain.

  • Majority of Millwork installations completed. Only departure desks remain.

  • Arrivals Reclaim Baggage Handling System (flat plate carousel) installations complete

  • Roof systems completed

  • Phase 1 apron pours complete, majority have been cut and sealed

  • Plaza walkways and emergency road pouring ongoing, nearly completed. Landscaping ongoing

  • Majority of electrical energizations complete/signed off

  • Wastewater treatment plant commissioned – UV / waste system to be started up end of month.

  • Phase 1 exterior lighting systems installed, commissioned and site personnel training completed.



SEPTEMBER 2025 UPDATE

  • Only Check-in Hall Tiling Remaining. Majority of wall tiling complete.

  • Majority of Millwork installations completed. Only check-in hall and departure desks remain.

  • Exterior stucco installation complete.

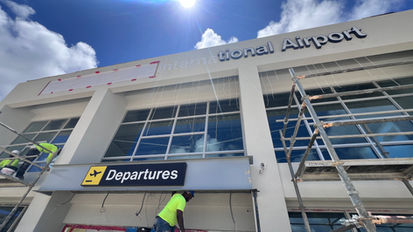

  • Building wayfinding signage installation complete.

  • Baggage Handling System installations underway

  • Roof Membrane and thermal paint installation complete

  • Majority of phase 1 apron areas complete.

  • Ceiling installation in check in hall completed. Installation of speakers and lighting ongoing.

  • Taxi-stand shade structures, drop off road and parking lot complete. Focus is on completing the last portion of the plaza area.

  • East and West side of the building inspected and approved for energization (should see lights and HVAC on in most of the building by end of first week of October).

​

AUGUST 2025 UPDATE

  • Majority of floor tiling completed throughout building. Wall tiling installation commenced.

  • Majority of drywalling completed throughout building.

  • Stucco installation completed on roof and majority of first coat completed on exterior.

  • Commenced panel installations of final apron area

  • Ceiling installation in check in hall commenced

  • Majority of mechanical equipment installed in primary mechanical room

  • Majority of Plaza taxi stand steel shade structures installed

  • Mahogany tree road fully poured (only driveways/entrance lanes to taxiway and parking lot remain)

  • Commenced Landscaping scope/plantings

  • 50% complete wastewater treatment plant installations (comms, sanitary lines, control room, holding tanks and lift station)

  • Building wayfinding signage scope commenced

​

JULY 2025 UPDATE

  • Drywall, painting, and tiling completed in West side of building (Sector C)

  • Roofing waterproofing system completed. Only reflex white paint is required to complete scope.

  • Majority of mechanical infrastructure installations complete throughout building (HVAC, Fire Suppression, STW Drainage, Plumbing)

  • Completed majority of stucco installations on roof

  • Commence exterior stucco and finishes installations

  • Commenced washroom finish installations (toilets, sinks, tiles, etc.)

  • Primary switchboard (DP-A) energized inside ATB electrical room

  • Majority of Mahogany Tree Road Concrete Pouring completed

  • Apron PCC lanes poured for areas ‘F-1’ and ‘F-2’ (One area remaining to complete phase 1 scope)

  • Airside light masts installation commenced (4 installed)


JUNE 2025 UPDATE

  • Completed all window installations

  • Completed all sliding door installations

  • Completed all internal door installations

  • Commenced Roof Waterproofing

  • Commenced Acoustic Tile Ceiling Installations

  • Airport Office Tiling Completed (moved works to Arrivals Immigration and Baggage Reclaim)

  • Commenced Bulkhead/Drywall Installations in Mezzanine

  • Commenced Mahogany Tree Road Concrete Pouring (Kerbs)

  • Commenced Taxi/Drop Off Road Concrete Installations


MAY 2025 UPDATE

  • Majority of windows (both internal and external) installed

  • Majority of external doors installed

  • Commenced installation of internal doors

  • Mechanical units ‘landed’ on roof

  • Majority of parking lot poured

  • Roof concrete pouring completed

  • Wastewater Treatment Plant Holding tank walls poured

  • Airport office drywall completed

  • Airport office tiling installation commenced


APRIL 2025 UPDATE

  • Commenced window installations (Completed exterior window installations for Airport offices)

  • Completed West side mechanical and electrical room finishes

  • Commenced installation of fire suppression systems on West side of building

  • Commenced installation of HVAC on east side of building, in airline offices

  • Check in hall high walls poured. Architectural structural steel installations ongoing

  • Commenced installation of exterior fixed canopies

  • Continued installation of roof decking and steel on East side of building. The roof is scheduled to be completed (fully poured) by first week of May

  • First run of Apron trench drain poured/installed

  • Majority of landside storm water outlet installations complete (one headwall remaining)


MARCH 2025 UPDATE

  • All ground-floor concrete walls completed (poured)

  • Finalized masonry wall installations in the Arrivals baggage reclaim area

  • HVAC installations ongoing throughout Western third/section of the building

  • West side Mechanical & Electrical Rooms blockwork completed

  • Drywall stud and gypsum board installation ongoing in West Office areas

  • Departure hold area roof decking/scaffolding installations ongoing & roof slab pouring ongoing

  • Storm Pipe & Trench Drain Installation Ongoing (Majority of Airside STW scope complete)

  • Continued WWTP Installation. Blinding poured; foundation steel installed

  • Continued airside and landside lighting installations. Foundations poured; conduits routed


FEBRUARY 2025 UPDATE

  • All Floor Slabs completed (poured)

  • All roof slabs and inverted beam poured/completed from GL 8 – 14 (The Western third of the building).

  • Finalized masonry wall installations in the Arrivals baggage reclaim area, and continuing installations along on the West side of the building

  • HVAC installations ongoing throughout Western third/section of the building

  • Drywall stud installation started

  • Commenced Wastewater Treatment Plant Installation

  • Commenced Airside and Landside lighting installations

  • East side future parking lot caliche placed and compacted


JANUARY 2025 UPDATE

  • Contractor remobilized from Christmas Break

  • Eastern Cistern Backfilled and Substructure Works Complete

  • Continue installations of West superstructure walls and roofs.

  • Mezzanine Floor Slab Poured

  • Baggage Reclaim Roof Poured

  • Majority of Phase F-1 Apron works completed

  • Airside STW and outfall installation close to completion (minor works remain)

​

OCTOBER 2024 UPDATE

  • Majority of Substructure Completed (Only East Cistern and a few step footings remain)

  • All external Eastern Stormwater Cistern Wall Poured, once internal walls are poured, and external walls are cured we will begin the top slab (final steps of the substructure)

  • Continued installations of West superstructure walls, started forming SW structure roof slabs

  • Apron works Continued – 50% PCC apron pour completed

  • Begun airside STW and outfall installations during night shift (completion expected in coming weeks)


SEPTEMBER 2024 UPDATE

  • Majority of Substructure Completed

  • Majority of external Eastern Stormwater Cistern Wall Poured (1 Pour Remaining)

  • Commenced installations of West superstructure walls

  • Existing Cargo Facility Demolished

  • Apron works ongoing – first PCC apron pour completed, and majority of stormwater infrastructure installed on landside area


AUGUST 2024 UPDATE

  • Western Potable Water Cistern Poured

  • Eastern Stormwater Cistern Slab Wall reinforcing steel completed, wall form installation ongoing

  • Foundations/Column/Shear Keys Completed. Substructure Walls Ongoing

  • Phase 1B Airside Works ongoing – excavations complete, lean concrete base pouring ongoing.


JULY 2024 UPDATE

  • Half of Western Cistern Walls Poured

  • Eastern Cistern Slab Wall reinforcing steel installation close to completion

  • Foundations/Column/Shear Keys installations ongoing

  • Phase 1B Airside Works ongoing – excavations complete


JUNE 2024 UPDATE

  • Western Cistern Slab poured, and strength confirmed. Steel installation for walls ongoing

  • Eastern Cistern Slab poured

  • Foundations/Column/Shear Keys installations ongoing

  • Site fencing erected next to existing cargo building, to allow for Stormwater/Trench Drain Installations


MAY 2024 UPDATE

  • Gates/Fences fully installed (site is now fully enclosed).

  • Western Cistern excavated, blinding poured and steel installation ongoing.

  • Majority of Eastern Cistern Excavation Complete

  • Foundations/Column excavations ongoing

  • Aecon site fully mobilized.

​

APRIL 2024 UPDATE

  • New Air Terminal Building

    • Ground-breaking Ceremony & Beginning of Site Mobilization

    • Delivery of project material and equipment

    • Tree Relocations and Clearing of site vegetation and topsoil.

    • Construction of site fencing, pedestrian walkways, and parking lot improvements

  • Apron Expansion

  • New Airside Access Road

  • New Landside Parking Lot, Airport Roads, and Pedestrian Plaza

​​

MARCH 2024 UPDATE

Phase 2B - Air Terminal Building - Commencing March 2024

  • New Air Terminal Building

  • Apron Expansion

  • New Airside Access Road

  • New Landside Parking Lot, Airport Roads and Pedestrian Plaza

Package 3B - Apron Expansion

PHOTOS COMING SOON...

Package 4 - Airport Expansion

PHOTOS COMING SOON...

A Vision Supported by Global Partnerships


The transformation of Clayton J. Lloyd International Airport into a world-class facility is propelled by generous support from the UK International Program. This redevelopment is a testament to our commitment to enhancing our capabilities and ensuring that the airport remains a key hub for international travel. Our vision extends beyond expansion; it's about creating a legacy of connectivity and service excellence for generations to come.

Project Contacts

​

Kendell O. Richardson

Government of Anguilla

Kendell.Richardson@gov.ai

+1 264-476-7669

www.gov.ai

​

​

Jabari Harrigan

Anguilla Air and Sea Ports Authority

Jabari.Harrigan@aaspa.ai

+1 264-584-9642

www.anguillaports.com

Website Management:


© 2024 by AviaNG

bottom of page
